|
|
|
|
|
|
|
|
Getting It Up:
the erection of craig's big column
by Cindi
|
|
|
29/8/2007
|
|
|
|
|
|
Craig and his labourers Ben and Johan had a conundrum... how to
move a 200kg + tree trunk that was to be the central column for

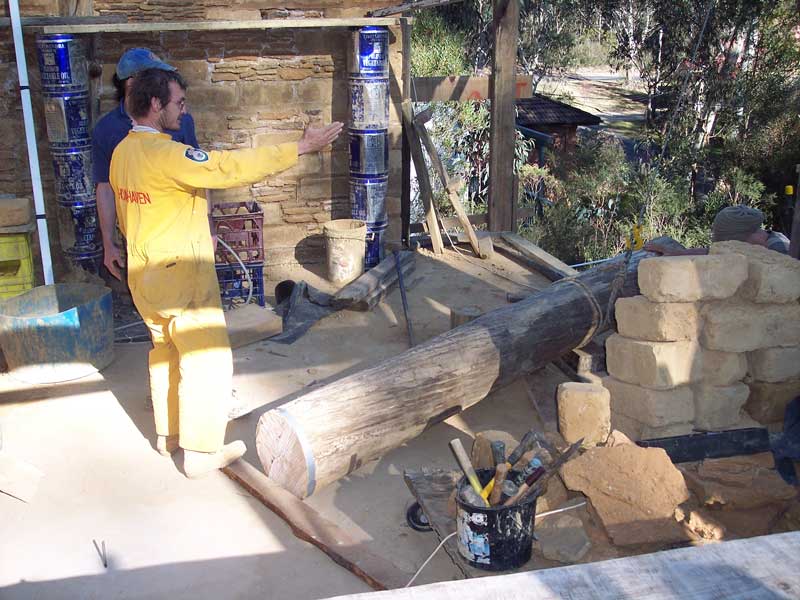

the main room of the house. Initially it lay just where the tree

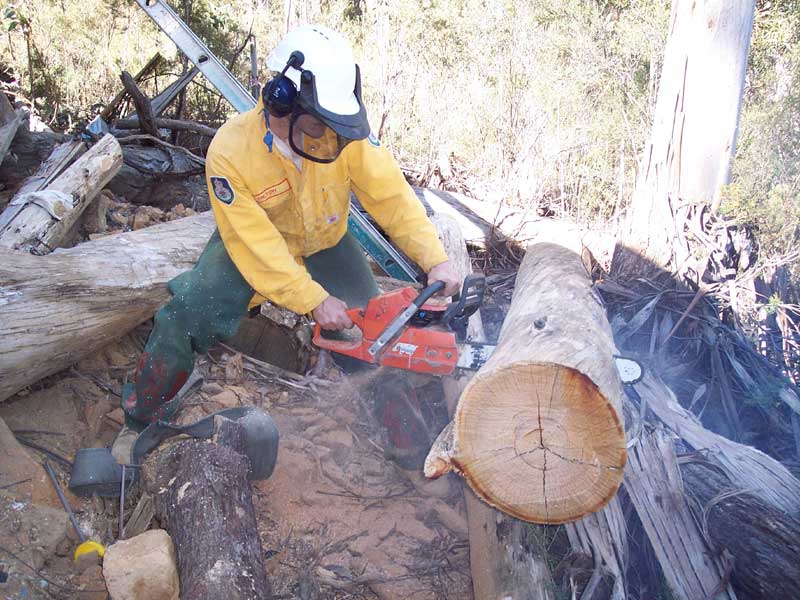

had been felled, and today Craig chainsawed it to the correct length.
But how to move this beast into its final position?
|
|
|
|
|
|
To begin with, a steel cable was attached to a heavy duty sling
cinched around the near end. The cable was threaded through a pulley
and attached to a hand-winch. Craig slowly jacked the winch and the
boys spotted the column as it was pulled across boards placed to
prevent scratching. Using this technique the column was dragged about
ten metres forward to the front of the house, safely past the electricity
safety box, and then a three point turn needed to lift it up onto
the slab was successfully negotiated. |
|
|
|
|
|
|
|
|
|
Looking important is necessary |
|
|
|
|
|
|
|
|
|
|
|
At this stage everything was going relatively smoothly, as a 200kg
log being dragged along the ground doesn't have anywhere to fall
to or onto.
But now, the massive log needed to be erected in its final position,
at the centre of the main room, positioning its base on a piece
of reobar as the locating pin. This was attempted first by winching
the log's far end closer, while using will power and some small
bits of wood as a pivot to hold the base in place. As to be expected,
willpower wasn't enough, but fortunately the log wasn't too high
up to cause any damage as it began to rotate rather than lift,
and we were able to quickly put some chocks under it.

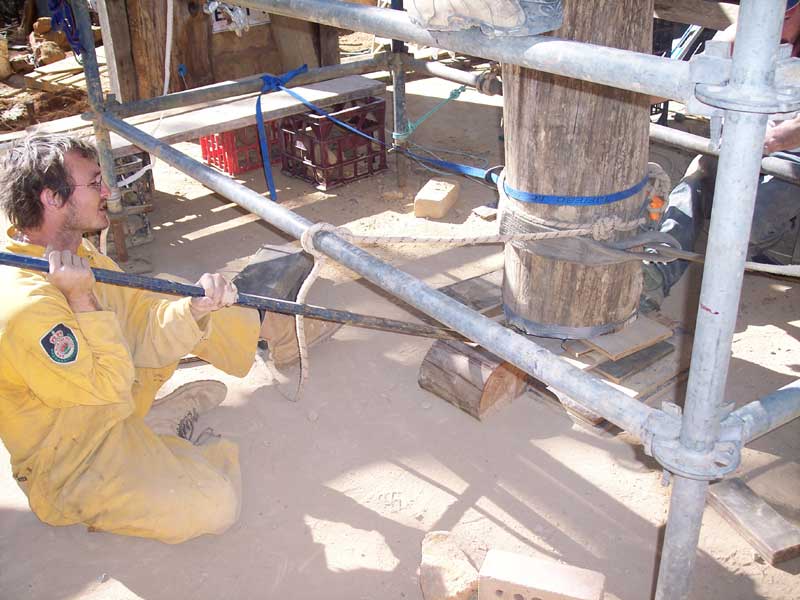

At this point the lads began using brains rather than brawn, and
brought in a steel scaffold system which was erected around the
column to support it during the lifting. The scaff legs, and the
base of the log, were tied off to the front of the house, to prevent
these from sliding forward as the top of the log was winched toward
the rear of the house.

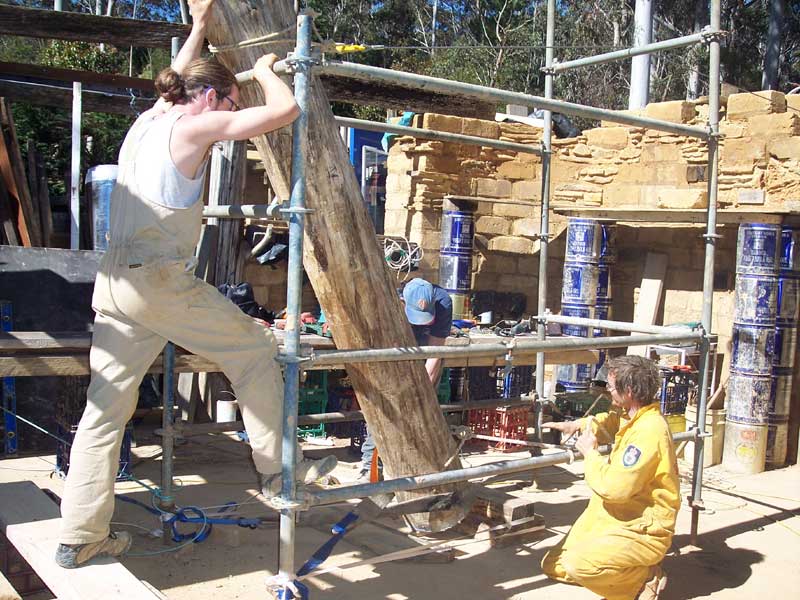

Slowly, the large column was winched upwards, and every so often
the scaffold was reset to provide a safety position should one of
the ropes fail. As the column was winched, it began to pivot on the
base that was locked in position, and we were able to get some blocks
underneath it so that it did not crush the reobar pin that was already
in place. |
|
|

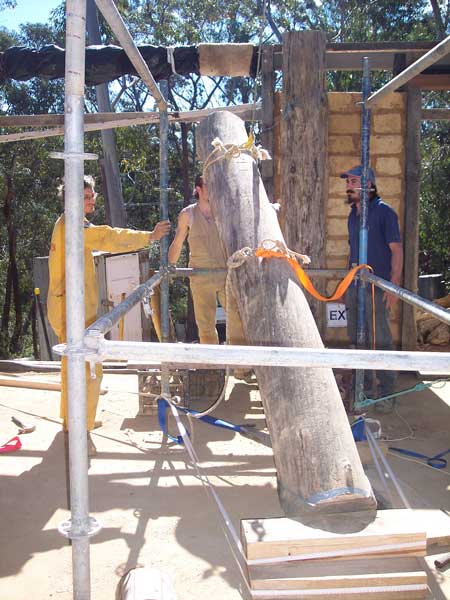

Finally the column was vertical, resting on two large blocks,
with the pin underneath. How now, to lower it onto the pin? Firstly,
the blocks were replaced by stacks of packers (5 and 7 ply boards
of varying sizes, that just happened to be at hand), which were
positioned by raising the log using a pinch bar as lever, quickly
substituting block for packers.
|
|
|

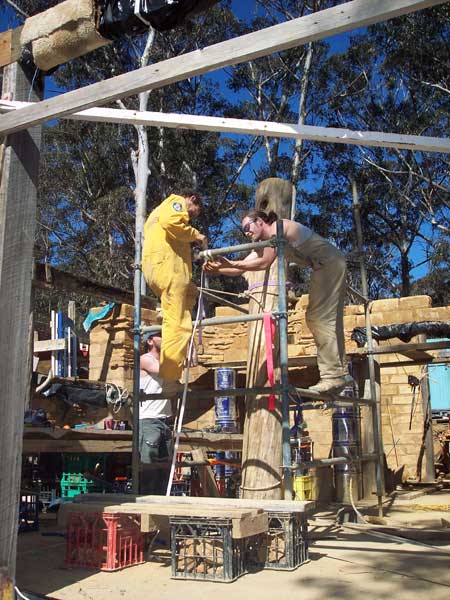

Now that the log was on packers, it was moved inch by inch until
the hole at the base of the log was located directly over the pin.
This took a bit of precision choreography, Craig lifting the base
with the lever, Johan moving the top with his muscle, and Ben using
his keen eye to get the position right. Now it was correctly aligned,
Craig levered the column up as Ben pulled out the packers one by
one. Thus the huge column was gradually lowered onto the pin. Cement
and Mastick were packed into the join to seal it.
Once it was in place, the column was checked for vertical alignment
and level, and three braces attached to keep it in position.
With that huge log now vertical, the main room looks very solid.
Good work to the team for getting it up!
Now it's time to cut the last of the top plates and connecting
beams, and we will see the roof go up.
|
|
|
|
